Create your Task subprocess diagram Figure 3: Create your Task subprocess diagram.

In the first article in this series, Designing an event-driven business process at scale: A health management example, Part 1, we began by defining the business use case and data model for a concrete example from the health management industry. We then began implementing the example in jBPM (an open source business automation suite) by creating our trigger process.

Now, in the second article in this series, we will focus on creating the Task subprocess and its many components. In our case, these are:

  • The Expired? gate
  • The Suppressed? gate
  • The human task
  • The Reminder subprocess
  • The "What type of close?" gate
  • The Hard Close embedded subprocess
  • The Escalation subprocess

The Task subprocess

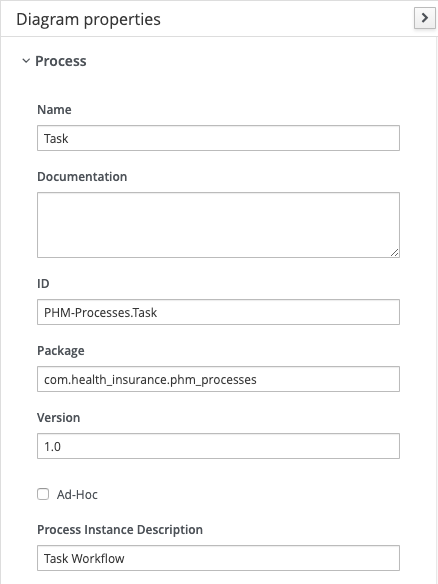

Now you can create the Task subprocess with the properties shown in Figure 1.

jBPM Diagram properties section, Process subsection

Figure 1: Create the Task subprocess.">

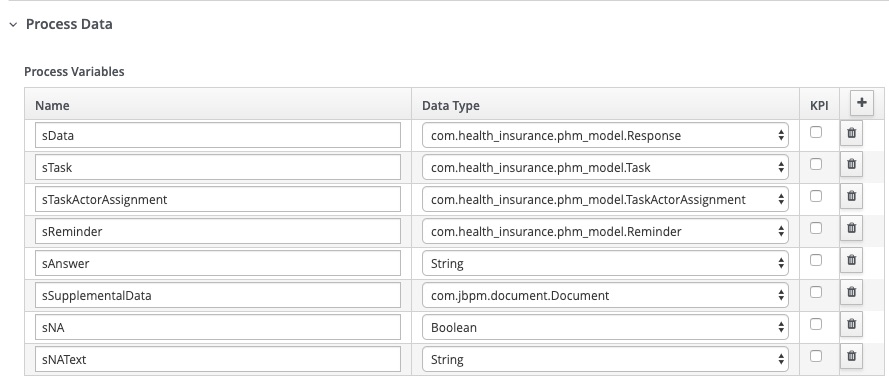

The Task subprocess needs the variables shown in Figure 2 to be defined.

jBPM Process Data section, defining process variables

Figure 2: Define the variables for your Task subprocess.">

Note: The type com.jbpm.document.Document of the variable sSupplementalData is available out of the box.

Now, draw the diagram for the Task subprocess, as shown in Figure 3.

Create your Task subprocess diagram
Figure 3: Create your Task subprocess diagram.

Figure 3: Create your Task subprocess diagram.">

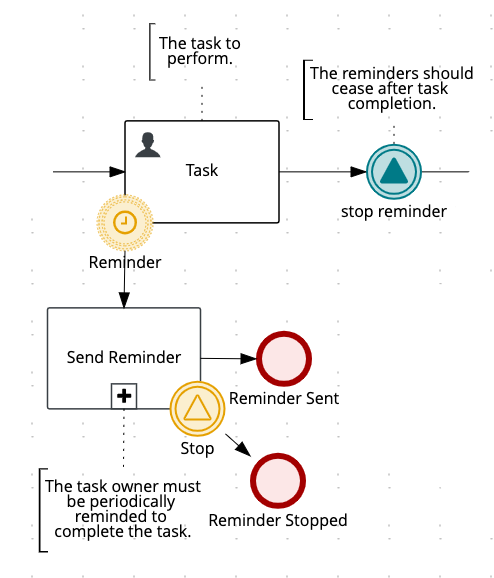

Once the process variables are initialized in a script task, a user task must be completed. A reminder is set for the completion of the user task and an escalation is defined. Both the reminder and the escalation are implemented with timers that lead to subprocesses that you need to implement. See below for a note concerning timers from a scalability perspective.

Note: We implemented the task suppression requirement using a timer as well.

The hard close requirement is realized as an embedded subprocess that is simply catching a signal. Following the requirements, the escalation occurs due to a timer on this subprocess.

The Expired? gate

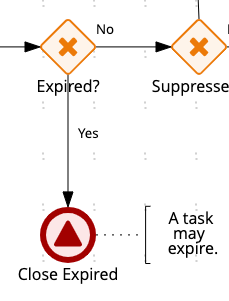

The Expired? exclusive gate should have two branches configured using the expirationDate attribute of the Task class, as shown in Figure 4.

jBPM diagram showing the expired gate in place

Figure 4: Checking if the task is expired.">

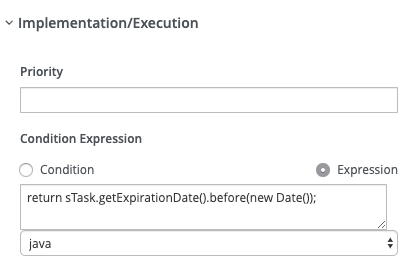

To configure the Yes branch, set up the condition expressions shown in Figure 5.

jBPM settings for what to do if the task is expired.

Figure 5: Defining the behavior if your task is expired.">

The Suppressed? gate

The Suppressed? exclusive gate's two branches should be configured using the suppressed boolean attribute of the Task class, as shown in Figure 6.

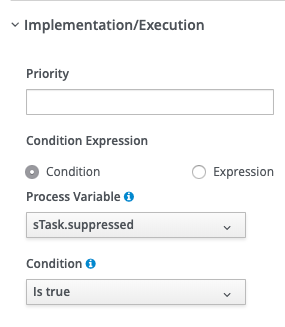

Defining behavior depending on whether or not your task needs to be suppressed.
Figure 6: Defining behavior depending on whether or not your task needs to be suppressed.

Figure 6: Defining behavior depending on whether or not your task needs to be suppressed.">

Figure 7 shows the configuration for the Yes branch.

jBPM configuration for suppressing a task

Figure 7: Entering the Yes branch.">

The suppression of the task is accomplished by a timer. The timer causes the process to wait for the period specified in the Task object's suppressionPeriod attribute, as shown in Figure 8.

Defining the suppression timer

Figure 8: Defining the suppression timer.">

The human task

Now, let's focus on the human task, as shown in Figure 9.

Defining the human task.
Figure 9: Defining the human task.

Figure 9: Defining the human task.">

Configure the human task using the settings shown in Figure 10.

jBPM showing task actor setup

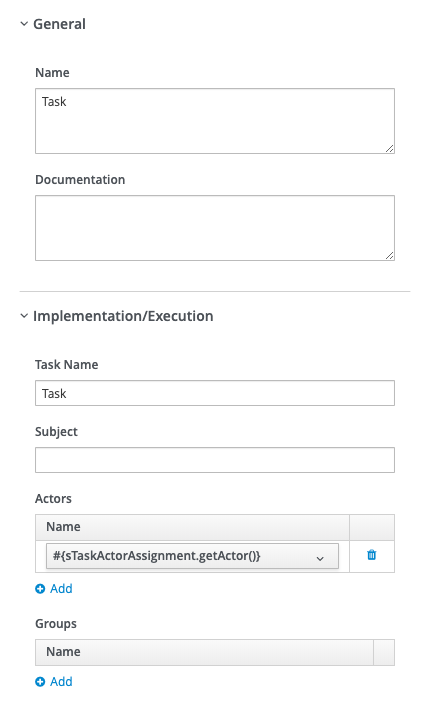

Figure 10: Implementing the human (actor) task.">

The task actor is resolved from the task actor assignment process variable.

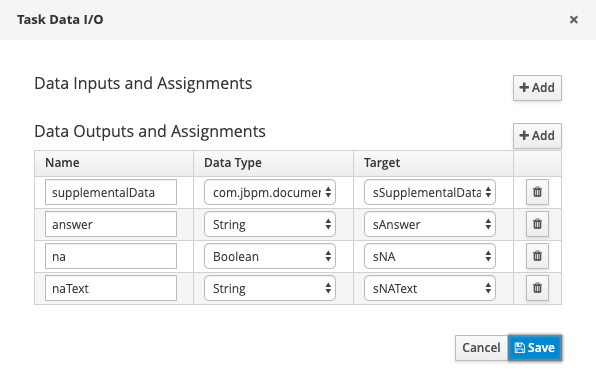

Next, there are a couple of abilities you will want: To capture text as well as supplemental uploaded documentation and to complete the task with a Not Applicable or Not Available response. These requirements can be satisfied by configuring the task parameters as you see in Figure 11.

JBPM Data Outputs and Assignments section filled in for this task.

Figure 11: Defining the task's parameters to capture the types of data you need.">

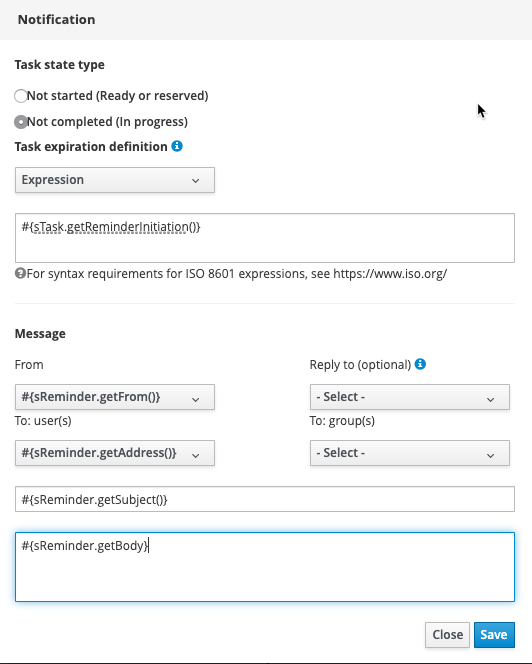

You also need to satisfy the requirement of sending a periodic reminder to the task actor. There is a built-in notification capability in jBPM that allows sending email to notify groups and individuals to complete a task. For example, you could configure notifications for the Task activity as you see in Figure 12.

jBPM Notification configuration for task state type not completed.
Figure 13:
Figure 12: Reminding your humans to complete their tasks.">

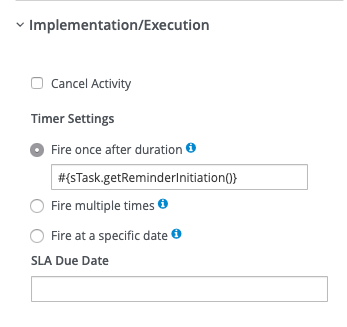

In many cases, the built-in notification capability may be adequate. However, there are cases where one would need more control over the notification process. The advantage of using timers for this purpose allows you to design as complex a reminder process as you want. In this example, you will implement timer-based reminders.Configure the timer on the task border, which will trigger the first reminder after the period of time defined in the reminderInitiation attribute of the Task object as shown in Figure 13.

jBPM implementing the first task reminder
Figure 13: Triggering the first reminder.">

The Reminder subprocess

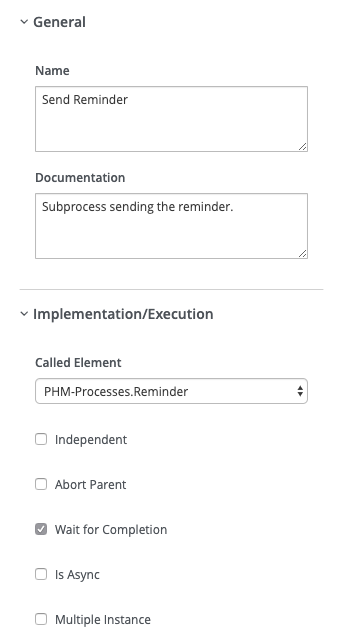

Now you should configure the subprocess Reminder, as shown in Figure 14. Notice that both the properties "Independent" and "Abort Parent" must be left unchecked while "Wait for Completion" is checked. If you don't configure it in this way the Reminder subprocess will not stop as it should.

Creating the Reminder subprocess.
Figure 14: Creating the Reminder subprocess.
Figure 14: Creating the Reminder subprocess.">

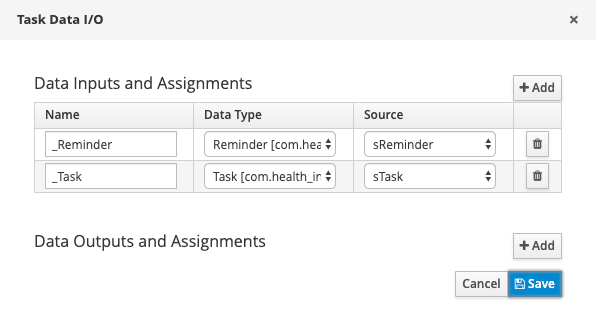

Set the subprocess parameters to be the Reminder and Task objects, as shown in Figure 15.

Configuring the subprocess
Figure 15: Configuring the subprocess.">

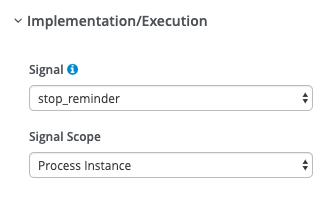

After completion of the task, a signal should be sent to stop the reminder subprocess, as shown in Figure 16.

Creating the stop signal.
Figure 16: Creating the stop signal.
Figure 16: Creating the stop signal.">

The "What type of close?" gate

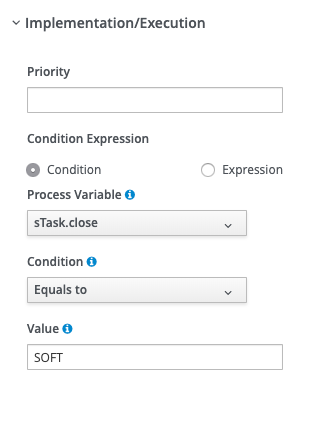

An exclusive gate decides if the task close state should be soft or hard. The soft close branch of the gate looks like what you see in Figure 17.

jBPM setting up for the value SOFT
Figure 17: Configuring the soft-close branch.">

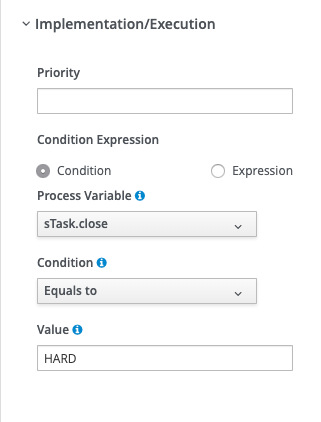

And the hard-close branch is shown in Figure 18.

jBPM setting up for the value HARD.
Figure 18: Configuring the hard-close branch.">

The Hard Close embedded subprocess

If the task close is hard, the process must wait for a confirmation signal coming from an external system. You have to configure this in an embedded subprocess because of the escalation requirement.

This subprocess is simple. There is just an intermediate signal catch, as shown in Figure 19.

jBPM catching the hard close signal.
Figure 19: Catching the signal for a hard close.">

You also need to implement an escalation subprocess if the task is not closed in a given time. Again, jBPM has a built-in capability to reassign a task if it is not completed in a timely fashion. For example, you could configure how to reassign the task as you see in Figure 20.

jBPM's Reassignment section set to escalate a task that was not completed in time.
Figure 20:
Figure 20: Escalating (reassigning) a task that wasn't completed in a timely fashion.">

However, you need to base the reassignment after receiving confirmation from an external system that the task was closed. Moreover, the period must be configurable as a variable, because this value depends on the specific task. Because of these reasons, you need to implement the escalation as a timer-triggered subprocess.

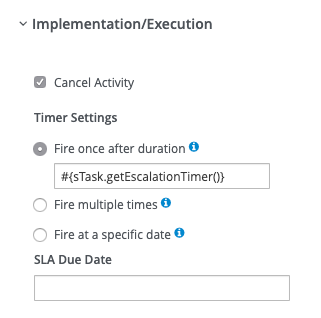

A border timer determines when an escalation is needed based on the value of the escalationTimer attribute of the Task object, as shown in Figure 21.

jBPM setting the task to fire once when it's time.
Figure 21:
Figure 21: Configuring the escalation border timer.">

There is yet another way to implement SLA escalations. The ProcessEventListener interface has two methods that capture the event of an SLA violation and can be implemented with custom code specifying what to do in such an event, as you can see in this example implementation:

/**
 * @param event
 */
public void beforeSLAViolated(SLAViolatedEvent event) {
    System.out.println(
           "Process <<"+
                   event.getProcessInstance().getProcessName()+
                   ">>-<"+
                   event.getProcessInstance().getId()+
                   "> ->SLA <<"+
                           event.getNodeInstance().getNodeName()+">>-<"+
                           event.getNodeInstance().getNodeId()+">-<"+
                           event.getNodeInstance().getId()+
                           "> SLA is about to be violated."
    );
}

/**
 * @param event
 */
public void afterSLAViolated(SLAViolatedEvent event) {
    System.out.println(
            "Process <<"+
                    event.getProcessInstance().getProcessName()+
                    ">>-<"+
                    event.getProcessInstance().getId()+
                    "> ->SLA <<"+
                            event.getNodeInstance().getNodeName()+">>-<"+
                            event.getNodeInstance().getNodeId()+">-<"+
                            event.getNodeInstance().getId()+
                            "> SLA has been violated."
    );
}

The Escalation subprocess

Now, configure the Escalation subprocess, as shown in Figure 22.

Creating the Escalation subprocess.
Figure 22: Creating the Escalation subprocess.
Figure 22: Creating the Escalation subprocess.">

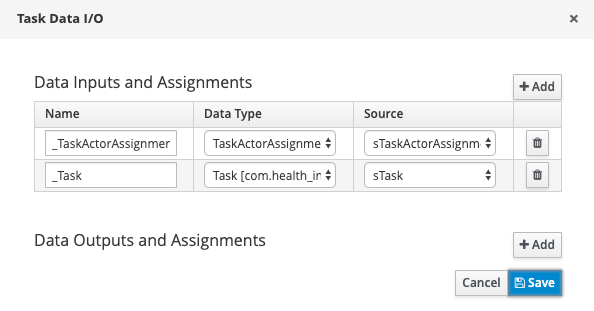

Then define the parameters of the subprocess. You need to pass the Task and the TaskActorAssignment objects, as you can see in Figure 23.

Figure 23: Defining the data the Escalation subprocess uses.">

Conclusion

So far in this series, we have defined the business use case for our health management event-driven business process, and have created our data model, trigger process, and task subprocess with all of its components. In the next installment, we will complete our example configuration.
